When One Pane Cracks: Choosing a Partition System You Can Maintain

Replacing one cracked pane should not mean dismantling the run. What makes a glazed office partition serviceable, and what to ask before you specify one.

By Vladimir Castravet·

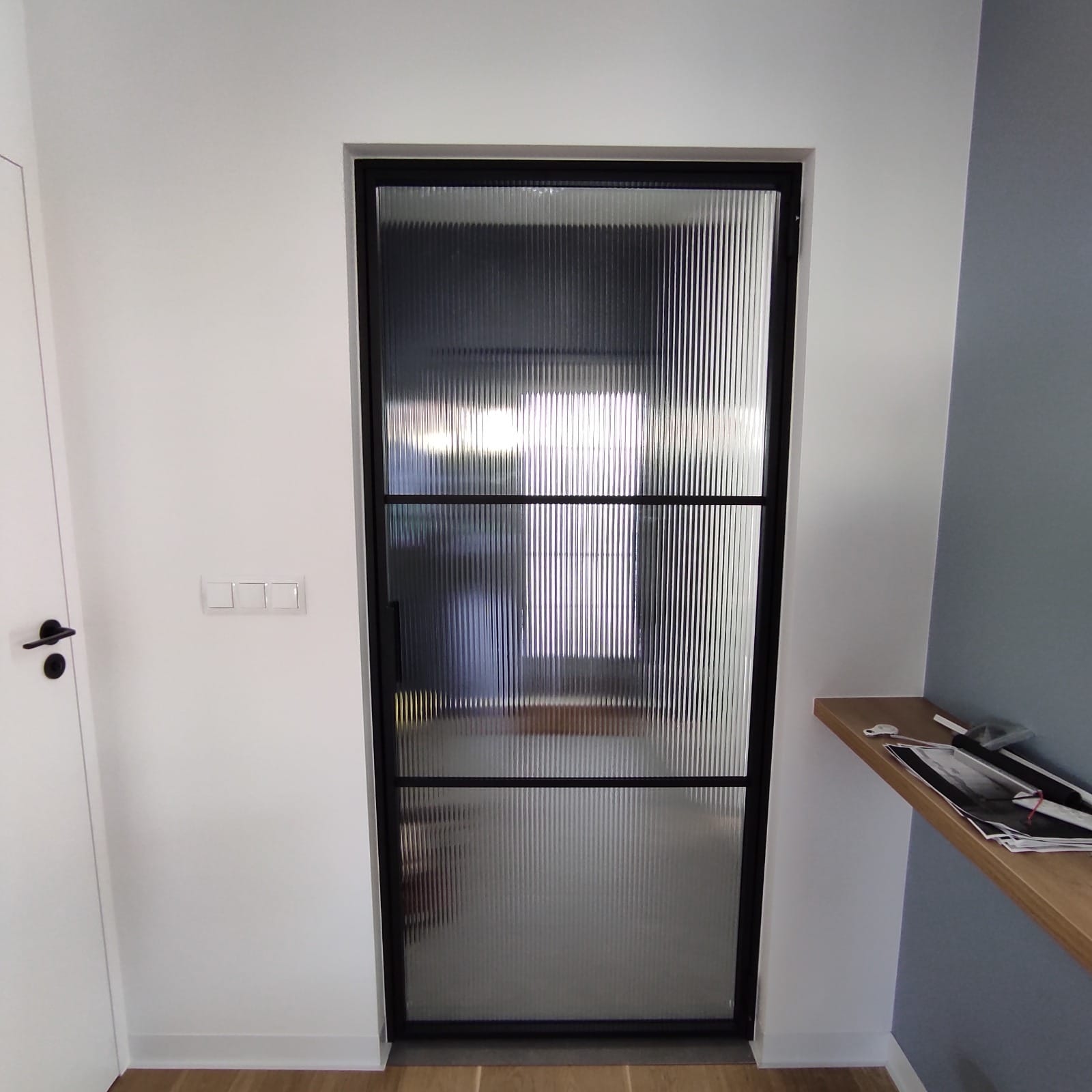

Internal door in reeded glass and a slim black steel frame, built by 2VP

On most glazed office partitions, replacing 1 damaged pane means dismantling the run from the nearest end — removing sound glass to reach the broken piece. On the systems we specify the frame unlocks at that bay and that 1 pane lifts out on its own. It is the property you will care about most in year 3, and it is invisible on a plan. Our commercial fit-out page covers how the work is delivered, and the partition reuse post sets out the waste case for demountable screens. A partition layout is priced from a survey, not a floor area.

Almost every conversation about glass partitions happens at design stage and is about how they look. Almost every problem with them happens three years later and is about how they come apart.


The question nobody asks at specification stage

A pane gets cracked. A trolley catches it, a desk goes in badly, a contractor leans a sheet of ply against it. This is not an unusual event on an office floor; it is a Tuesday.

What happens next is decided entirely by how the system was engineered, and nobody asks about it before signing.

The frame was built up in order, so the glass is trapped. Reaching a broken pane means working back from the nearest end and removing sound glass on the way. Good glass gets scratched, gasket gets damaged, and the area is out of use while it happens.
The frame is designed to be unlocked where the damage is. One pane out, one pane in, gaskets reused, the rest of the run untouched. The work is local, quiet and short enough to do outside trading hours.

The second costs nothing extra at design stage. It is a property of the system you chose, and it is invisible on a plan.

What to ask before you specify

Ask the supplier to take a pane out of a sample bay in front of you, and to put it back. Not a diagram, not a description — the actual removal. Five minutes of someone's time at tender stage answers a question you will otherwise ask for the first time with a cracked pane already in the building.

Three properties that separate systems

1 · The door matches the frame

A glazed run breaks visually at its doors. Where the door leaf and its frame carry deeper or wider profiles than the screen framing either side, the opening reads as a separate object inserted into the glass line. Where the door and the frame share the same profile dimensions, the whole run reads as one plane, and the door is given away only by its handle.

This is pure appearance, and it is the detail an architect spots across a room. Most systems do not hold the dimension through the door. The ones that do were drawn that way from the start.

2 · The frame is serviceable, not just demountable

Demountable and serviceable are two different properties and they get sold as one. Demountable means the run can be taken down and re-erected somewhere else — that is the waste and carbon case, and it is covered in the reuse post. Serviceable means you can get at one component without disturbing its neighbours, for as long as the run stays exactly where it is.

A system can be demountable and still be miserable to repair. Ask about both.

3 · The frame does work beyond holding glass

This is the one that changes drawings. Where the framing is engineered to take load and route services, it carries:

  1. 01Shelving. Fixed into the system rather than into a wall built specially to receive it.
  2. 02Solid timber infill panels. Opaque bays where privacy is wanted, in the same frame as the glazed bays, on the same sightline.
  3. 03A wall-mounted screen. A television or display fixed to the partition system itself, with the bracket loading confirmed by the manufacturer for the weight you intend to hang.
  4. 04Cable routing inside the system. Power and data run within the framing rather than in surface trunking or a void built to hide them.

Follow that through and a boarded wall sometimes disappears from the drawing altogether — the stud, the plasterboard, the skim and the decoration that existed only so something could be hung on it and cables could be hidden behind it. That is a wet trade removed from an occupied floor, and a gypsum waste stream removed from the end of the lease. The numbers behind the gypsum half of that are in the reuse post rather than repeated here.

I want to be careful about the environmental version of this claim, because it is easy to overstate. Not building an element is unambiguously better than building it and throwing it away. But a partition system is aluminium and glass, and on day one it carries more embodied carbon than board and studs do. The honest case is the one already set out in that post: the saving arrives from the second fit-out, and it arrives through reuse rather than through any single material being virtuous.

Changing the face without touching the frame

The rung below demounting is swapping only what people look at. A click-on, click-off panel system treats the framing as permanent and the design panels as consumable — so a rebrand or a refresh is one fitter taking panels off and clipping new ones on.

What that buys is not mainly material. It is four trades reduced to one: strip, board, plaster and decorate collapse into a panel swap, and there are no wet trades at all, so nothing has to dry before anything else can start. On a floor that is still trading, that is usually worth more than the material.

The caveat belongs in the same breath. Fire classification follows the panel, not the frame. Every new panel material has to be checked against Approved Document B for the room it is going into, and a frame confers nothing on whatever you clip to it.

What we will and will not tell you about these systems

We fit these partitions; we do not manufacture them. That boundary matters when you are reading a performance claim.

  1. 01What we will demonstrate. The frame unlocking and a pane coming out, the door-to-frame sightline, the panel swap, and what the framing will carry — in front of you, on a sample or on a delivered job.
  2. 02What we get in writing from the manufacturer. Fire classification for the panel build-up, acoustic figures for the exact junction detail, and bracket loadings for anything you intend to hang.
  3. 03What we will not do. Quote a laboratory acoustic figure as a promise about your meeting room, or describe a maintenance mechanism we have not watched work.

2VP is the builder on these jobs, not a marketplace: one contract, one named project lead, and no introducer fee stacked on the build cost. Partitions arrive as part of the fit-out rather than as a separate supplier you have to co-ordinate — and where a run meets joinery, the cabinetry comes from our own workshop on the same programme.

Getting to a number

A partition layout is priced from a measured survey: bay widths, door positions, head and floor conditions, what the framing has to carry and what the acoustic requirement actually is between which rooms. Those are the variables, and none of them can be read off a floor area.

Common questions

Straight answers

The 2VP Certainty Package

The home you actually want, finished on the date in the contract — and you watch every day of it happen from your phone.

Your number in 60 secondsItemised stage breakdown in 2 minutesSurvey within 7 days

You answer 3 questions. We do the drawings, planning, party wall, trades and snagging.

Before anything is signed
Full measured survey + 3D design visualisation
You see the finished room before you commit to building it
£1,500
RIBA architect design by Nick Elias
Concept, planning and technical drawings by one named architect
£8,000–£15,000
Completion date written into the contract
A date you can plan a life around, not 'TBC at build start'
Included
While we build
No variation without your written approval
Nothing is added to your bill that you did not sign for first
Included
Friday video walkthrough of your site, every week
You know what happened this week without driving over
£1,200/yr
One named project lead, one channel, 24-hour response
You never chase a company — you message a person
Included
Daily photo diary + client dashboard
Everything photographed before it is covered up
Included
Fixtures at our trade pricing, passed through at cost
Our discount is yours, not a margin we keep quiet about
10–20% on materials
After we hand over
6-month snagging visit
We come back once the house has moved and settled
£750
12-month workmanship warranty on second-fix fittings, signed by the trades
The people who built it are on the hook for it, by name
Included
Annual check-ins for 2 years
We come back. Every year. No charge.
Included
Our guarantee
We finish on the agreed date, or we pay you £500 for every week we are late.
The date is in the contract, and so is this. Only a variation you approve can move it.
What you are not risking
  • 10% to mobilise, then weekly against work already done — with 5% held past handover: 2.5% released at practical completion and 2.5% at the end of the 12-month defects period
  • £550 survey fee credited in full against your contract
  • Every variation priced and signed before a penny is spent
4.8★ from 17 Google reviews — including the 1-star, published in full.
Get my price in 60 seconds

No email needed to see your range. Quotes hold for 21 days, then materials re-price.

We are not the cheapest. If price is the only factor, we may not be the right fit — and that is fine.

Get my price in 60 secondsBuilders in your areaAll cost guides
If this is your project

The home you actually want, finished on the date in the contract — and you watch every day of it happen from your phone.

How fast
  • Your number in 60 seconds
  • Itemised stage breakdown in 2 minutes
  • Survey within 7 days
What you do

You answer 3 questions. We do the drawings, planning, party wall, trades and snagging.

What protects you
  • 10% to mobilise, then weekly against work already done — with 5% held past handover: 2.5% released at practical completion and 2.5% at the end of the 12-month defects period
  • £550 survey fee credited in full against your contract
  • Every variation priced and signed before a penny is spent

The date is a term of the contract. We finish on the agreed date, or we pay you £500 for every week we are late.

Do not take our word for it

4.8 from 17 Google reviews

Every review is published in full on our reviews page, including the one-star. Google is the only platform we quote a rating for, because it is the only one we can evidence.

★★★★★
As a structural engineer, I've collaborated with 2VP Projects Ltd on several residential projects in London. Their attention to detail, proactive site management, and clear communication make every stage—from design to execution—smooth and efficient. It's rare to find a contractor who values both precision and professionalism at this level. A truly reliable partner.
Igors Smirnovs · Structural engineer we have worked with · June 2025
★★★★★
Great company to work with. Professional, reliable and easy to deal with. Vladimir and the team are always responsive, straightforward and genuinely care about doing things properly. I've had a very positive experience working with 2VP and would happily recommend them.
Sheen Delicatessen · Business client · August 2026
★★★★★
Extension went smoothly from start to finish. Communication was great throughout, and the team delivered exactly what we asked for. Thank you, 2VP!
Dan Martea · August 2026
Warranties and protections

What is covered, and by whom

A builder’s own guarantee is worth exactly as much as the company standing behind it. Here is what comes as standard, what you can add, and what has to come from somebody other than us — set out in full on our insurance and guarantee page.

Included in the contract
  • 12-month workmanship warranty on second-fix fittings
  • £5M public liability
  • £10M employer's liability
  • £2M professional indemnity
Optional, on request
  • HomePro insurance-backed guarantee, 10 years
  • Priced at 2.5% of the contract sum
  • Underwritten by an insurer, so it survives us
Not from us
  • 10-year structural warranty on a new dwelling (NHBC / LABC / Premier)
  • Professional fees — architect, engineer, building control
  • We will tell you when you need one rather than let you find out
